[Prev][Next]


Cozy MKIV - Chapter 14

Building the Center Section Spar

Start Date: August 26, 1995

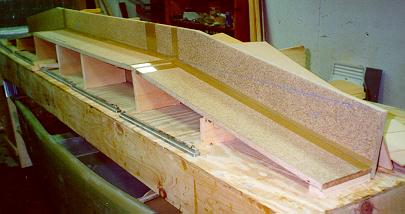

I started out by slicing a 3/4" particle board up into the pieces needed to construct the main spar jig. With these, shims, 3/4" pine boards, and a level, I put the jig together on my work table. You can see the jig here:

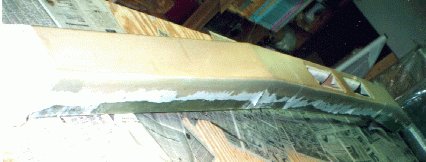

Next I cut out all the 3/8" and 1" foam for the spar and hot-glued it in place in the jigs while I micro'ed all the foam pieces together. Then I cut the BID and UNI glass for the interior layup. I then cut out the aluminum wing mount reinforcements and radiused the corners as needed. I was told that the interior layup would take a LONG time (maybe 8 hours or so), so I put off doing it until a Saturday. You can see the micro'ed foam pieces (with a top piece nailed in place for stability) ready for glassing here:

Well, in fact it took 2 1/2 weeks for the Saturday (actually a Sunday) to roll around - I didn't get to glass the interior until October 1. It did, in fact, take 7 hours, almost on the nose.

First, I micro'ed the left side of the spar, micro-filleted the horizontal and vertical corners, pre-wetted the 1 BID on saran wrap (as I did for ALL the subsequent layers of BID or UNI), and then diligently placed the BID into the spar cavity and smoothed it against the lower (rear) surface and the vertical sides (top and bottom). Next, I put 1 BID over the end bulkheads lapping 1" onto the three other surfaces, and then micro'ed the CS6 bulkhead in place. After pressing in nails to hold it in, I micro-filleted the corners and laid up 1 BID on either side of the bulkhead, lapping 5" where the LWA metal wing attach piece would later go.

Next, I glassed the BID and UNI for the LWA's (two outboard and one inboard). I then repeated the whole process for the right side of the spar (micro, fillet, glass, bulkhead, glass). After installing the center section BID as well, I installed the center bulkhead and glassed 1 BID on either side.

I then floxed all 6 LWA's (1/8" aluminum plates) in place over the future wing attach bolt positions. I covered these with BID overlapping 1" onto all adjacent surfaces, with flox transitions from the metal. You can see the LWA installation here:

inside LWA view

outer LWA view After trimming and sanding this layup flush and smooth, I cut the glass for the inner surface layups of the top (front) foam pieces (45 deg. BID) and glassed those foam pieces. Next (after trimming), I micro'ed the cured top pieces onto the spar box.

The next step was to cut and sand the spar cap troughs to shape per the depth templates, as well as create cutouts in the foam for the LWA4's and LWA5's (Wing metal attach plates). I floxed the LWA4's and LWA5's in place, and then I layed up the first half of the shear web - 4 plies of UNI glass at 45 deg.



shear web view You can see the first shear web layup here:

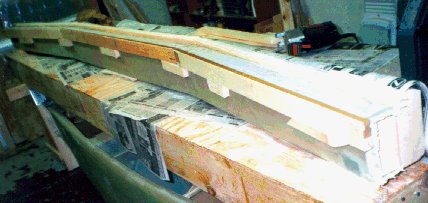

cap dam view After hot gluing a 1"x2" as a dam for the spar cap layup, I put in the 23 Layers of 3" glass rovings. This took about 8 hours. After trimming and sanding, I turned the spar over, and dammed and layed up the bottom spar cap 17 Layers).



spar cap view I cut and micro'ed the shoulder harness attach point block into place in front of the top spar cap, and then layed up the second half of the shear web - another 4 UNI plies. When this was semi-cured (big mistake!!) I floxed the LWA2's and LWA3's in place (more Wing attach metal plates) and laid up the UNI and BID reinforcing layups over the LWA's. The next day, I pulled the peel-ply off the reinforcing layups, and half the layups came with it!!! AAARRRRGGGGHHHH!!! It turns out that the 2427 epoxy I'm using doesn't like to have stuff attached to it when it's just gelled; either make sure the layup goes on while the previous one is still wet, or wait till it cures and then sand it. I removed the reinforcing layups, as well as 1 of the LWA3's, and sanded all the areas to reapply those layups. Where I had forcibly pried the LWA3 off, I had delaminated the second 4 UNI plies of the shear web, so I had to sand that off and feather the edges for a replacement 4 UNI plies. After re-floxing on the LWA3 and re-applying the reinforcing layups, everything was copasetic.



Next, I prepared the front of the spar by cutting out 5"x13" access holes and feathering the edges for glass-to-glass bonds. I layed up the 2 UNI plies onto the front of the spar, and made sure that the layup was pretty rich in epoxy, as it will be exposed to fuel in the fuel tanks.

After that cured, I trimmed and sanded all the previous layups, and then prepared for the last layups by making flox corners on the ends of the spar, and cutting 2.25" diameter holes out near the tips of the spar. These (along with the 5"x13" cutouts) are used for access to the wing attach bolts inside the spar. I layed up 1 BID ply over the ends of the spar, and micro'ed the holes so that there would be no exposed foam. After trimming and sanding these layups, I hung the spar up in the basement against the wall to wait until I have the room to install the spar into the fuselage in step 10.

On to chapter 9!!!


Hiatus Date: November 8, 1995


Hiatus End Date: May 15, 1998

Well, after a two and a half year wait and the purchase of a new house with a large garage, I began fitting the spar into the fuselage.

I carefully leveled my fuselage (up on the gear, now!) and then mounted the canard. [I had my second EAA technical inspector inspection a couple of weeks ago, done by Paul Adrien, and he suggested that when I mount the spar to have the canard mounted to use as a level reference]. I then mounted the spar in the rear cutout per the plans. I had to do a bit of sanding on the front surfaces of the cutouts to get the spar far enough forward so that there was 1/4" between the rear of the spar and the rear of the firewall and so that I could ensure the perpendicularity of the spar to the fuselage centerline. The plans were very good at describing how to do that.



Spar jigged to Fuselage You can see the spar shimmed and jigged in the fuselage in the photo.

After getting the spar shimmed level and square with the rear mounting faces vertical, I stood about 10 feet in front of the plane right in front of the nose, and then closed one eye. With the open eye (duh) I sighted over the canard and lowered my head until each side of the spar JUST disappeared behind the canard. I had to do a minor amount of shimming to get the canard and spar dead nuts level with each other - I could clearly note 1/10 degree over the 12 feet, and that represents about the limit of the levels I've got.

I made two EM-2's from aluminum. I then floxed and glassed them in place over the lower engine mount points with 1 BID.

So, after getting everything in place, I marked all my shims, sanded all the relevant areas, and then floxed the spar in place. I rechecked all the level, squareness, and canard parallelism again, and let it cure. I then glassed all the 2 and 3 BID tapes to hold the spar in. At that point it occurred to me that at no point did I consider the HEIGHT of the spar with respect to the fuselage - the plans did not talk about that issue. I poked around on the large sheets and found that the top of the spar was supposed to be at WL 22, exactly 1" down from the top of the main longeron at WL 23. So, out with the trusty ruler to find out where the heck my spar ended up. Arrgh. It's at 21 5/8". My cutout was a bit large, I guess, and instead of shimming it up flush with the top, I left it flush with the bottom.

I will NOT be cutting out my spar to raise it the 3/8" - in my opinion this is not aerodynamically important. However, it does have implications for attaching the strakes, which are supposed to be at WL 17.4. In my case, I will have to adjust that downward to WL 17.025 (WL 17, since I can't measure the 0.025 with a felt tip pen :-) ). My fuselage side cutouts for baggage compartment access will also have to be 3/8" lower. I did, however, want to bring this issue to everyone's attention so that they made sure to put the spar at the right level to save themselves the aggravation of having to adjust the strake height later on.

Finish Date: May 23, 1998
